Garage Conversion ADU — Convoy, San Diego | IL Total Design & Build

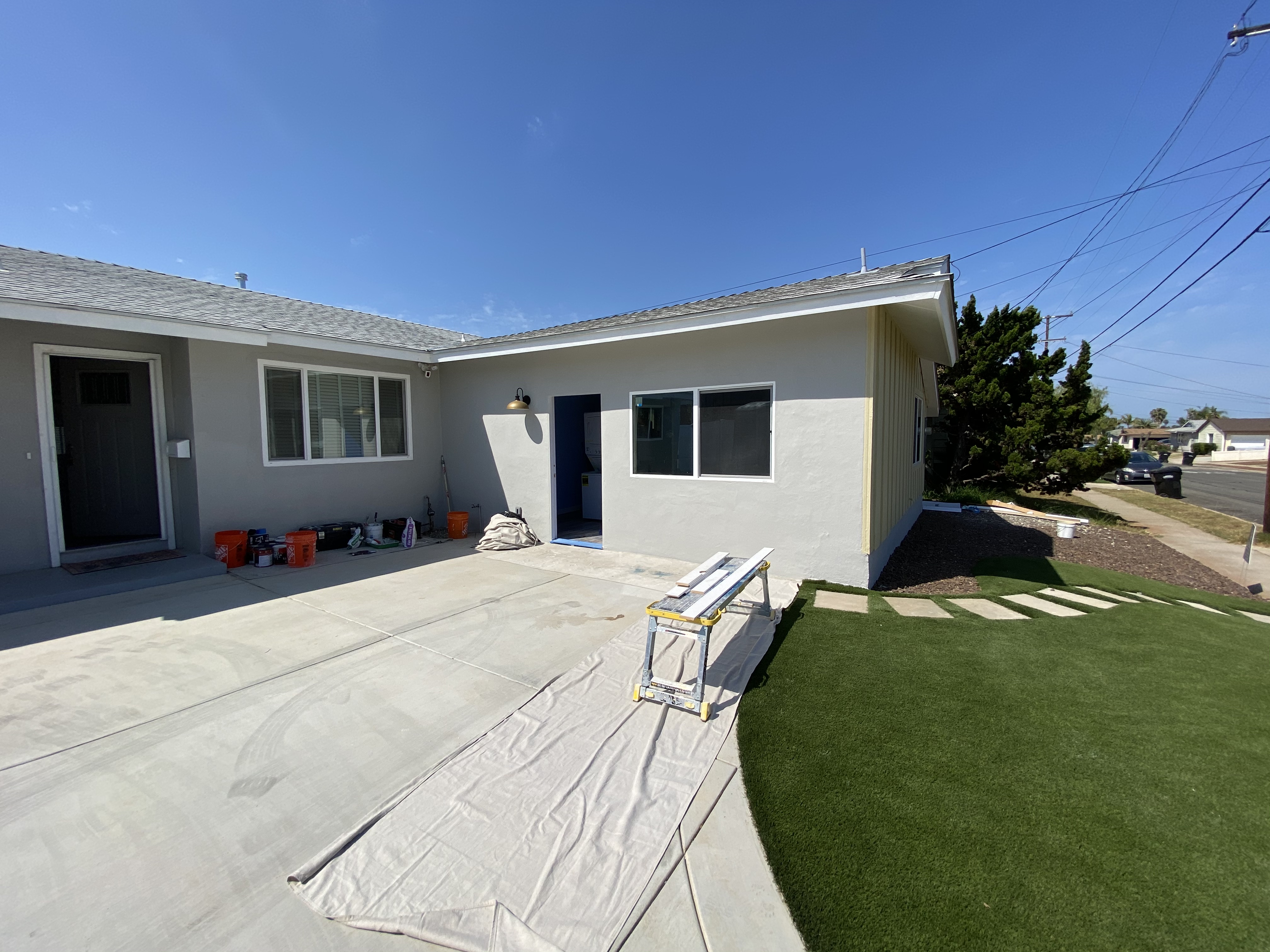

Converted garage ADU exterior in Convoy, San Diego — completed by IL Total Design and Build
Completed Project · 2025

Garage Conversion ADU — Convoy, San Diego

425 sq ft · Attached Garage · Full Kitchen & Bath · Multigenerational · IL Total Design & Build · CSLB #1058676

Location
Convoy, San Diego
ADU Type
Attached Garage Conversion
Size
~425 sq ft
Year Completed
2025
Total Cost
$150,000
Permitted
Yes — ahead of schedule
Use
Multigenerational / Family
Timeline
~7 months total

The Project

This Convoy-area homeowner had an attached garage sitting mostly unused — sharing a side wall with the main home but with no interior door connecting the two. The space looked like a garage. It functioned like a garage. But with family members needing a place to stay during extended visits, the homeowner saw something different: a private living space that could be right on the property without anyone feeling on top of each other.

They brought in IL Total Design & Build to make it happen. The goal was clear — convert the roughly 425 square feet into a fully functional ADU with a proper kitchen, bathroom, sleeping area, and laundry, all permitted and done right.

The positioning of this garage made it ideal for conversion. No interior access to the main home meant the ADU would have complete privacy from day one — no awkward shared entry, no sound between units. Family members would have genuine independence.

"We couldn't believe it didn't look like a converted garage anymore. It feels like a real apartment. Our family actually wants to stay longer now."
— Homeowner, Convoy · San Diego

The Challenge

Attached garage conversions in San Diego come with a specific set of constraints that detached builds don't have. The existing structure sets the rules — you work within its footprint, its ceiling height, its framing. There's no moving walls to optimize the layout. Every square foot has to be used intentionally.

At 425 square feet, fitting a full kitchen, bathroom, sleeping space, and stacked laundry while keeping the unit livable — not cramped — required careful planning at the design stage. The layout had to be efficient without feeling like a converted garage.

Constraints going in

  • Fixed footprint — 425 sq ft, no expansion possible
  • Existing slab, structure, and roofline dictated the layout
  • New utility connections required (kitchen plumbing, electrical upgrade)
  • Exterior must match main home aesthetics per city requirements
  • No interior access to main home — separate entrance only

What we delivered

  • Full permitted ADU with certificate of occupancy
  • Complete kitchen with appliances
  • Full bathroom with shower
  • Dedicated sleeping area
  • Stackable washer/dryer alcove
  • Private exterior entrance
  • Permits pulled ahead of schedule

Project Timeline

This project ran approximately 7 months from first consultation to certificate of occupancy — faster than a detached build because we were working with an existing structure, no foundation work required.

Weeks 1–2
Property Assessment & Feasibility
Site visit, zoning verification, utility locations confirmed, scope and budget agreed.
Weeks 3–10
Design & Permit-Ready Drawings
Custom floor plan developed, structural calculations, Title 24 energy compliance, permit application prepared.
Weeks 11–22
City Permitting
Submitted to City of San Diego. Approved ahead of the standard 60-day window with no correction rounds — clean first submission.
Weeks 23–32

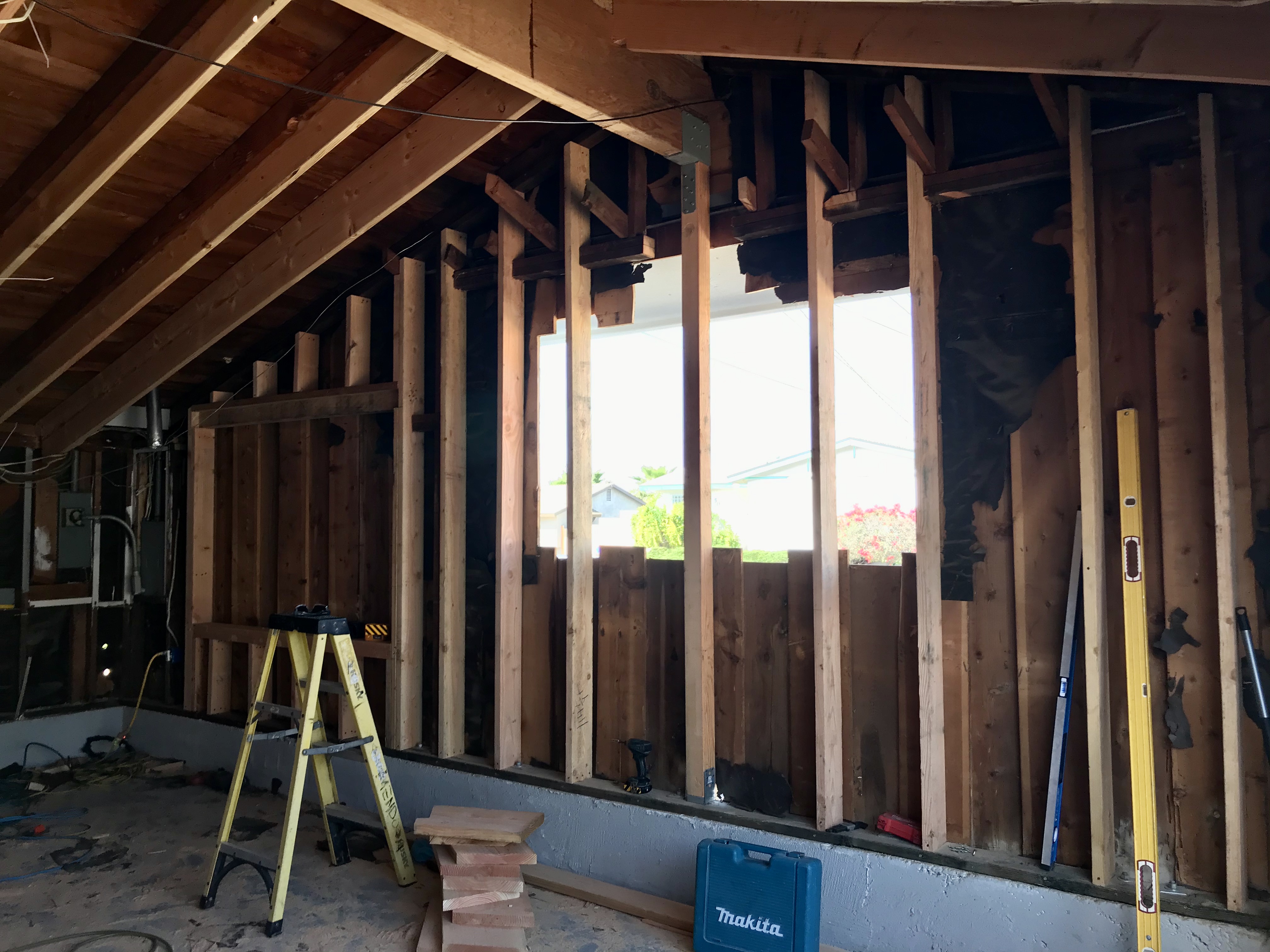

Construction

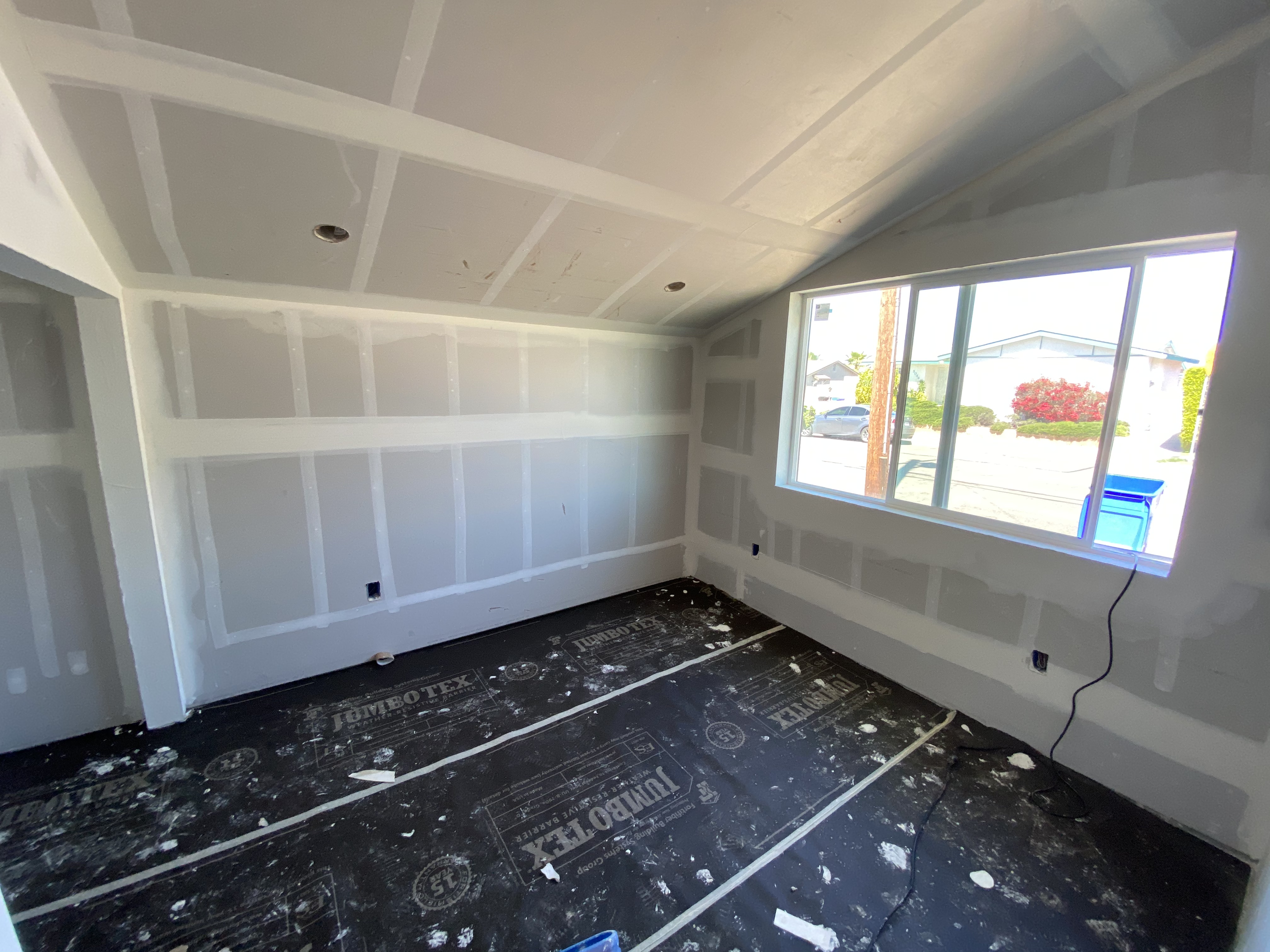

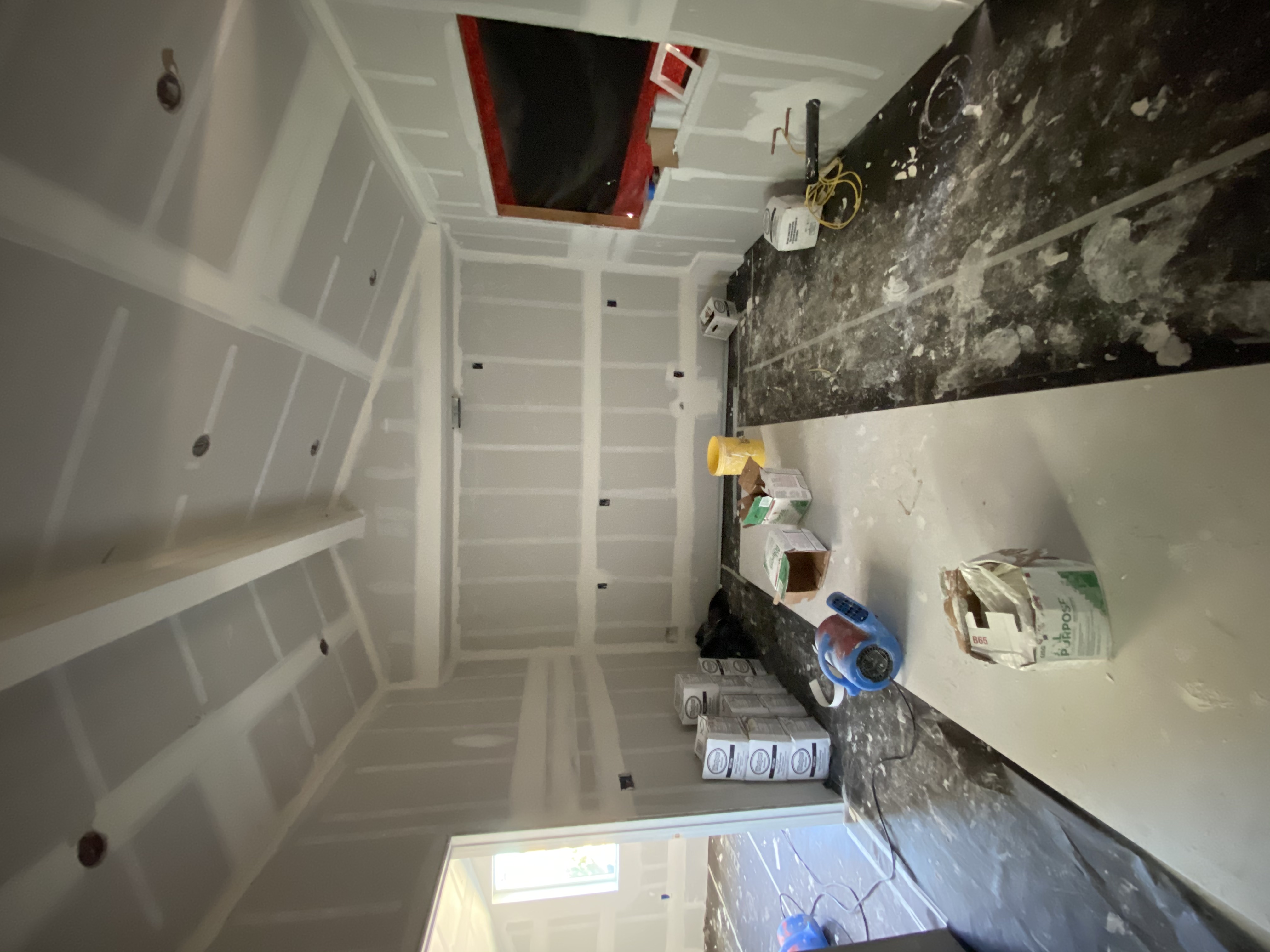

Demo, framing upgrades, plumbing rough-in, electrical, insulation, drywall, finishes, exterior treatment.
Week 30
Final Inspections & Certificate of Occupancy
All city inspections passed. CO issued. Unit legally habitable and ready for use.

Where the $150,000 Went

One of the most useful things a contractor can do is show you where the money actually goes. Here's the approximate breakdown for this 425 sq ft attached garage conversion:

Line Item Notes Approx. Cost
Design & engineering Custom floor plan, structural, Title 24 $8,000
Permits & fees Building permit, school fees, impact fees $9,000
Demolition & site prep Garage door removal, interior demo, cleanup $4,500
Framing & structural New exterior wall (garage door opening), interior framing $12,000
Electrical Panel upgrade, new circuits, fixtures, outlets $14,000
Plumbing Kitchen rough-in, bathroom, laundry connection $16,000
HVAC / mechanical Mini-split system, ventilation $9,000
Insulation & drywall Full insulation package, drywall, tape, texture $10,000
Flooring LVP throughout $6,500
Kitchen Cabinets, countertops, sink, appliances $18,000
Bathroom Tile, vanity, toilet, shower, fixtures $12,000
Exterior work New wall, siding, windows, entry door, paint $14,000
Miscellaneous & contingency Hardware, finish details, unexpected items $7,000
Total Fully permitted, move-in ready $150,000

Costs are approximate and reflect this specific project. Your project will vary based on existing conditions, finish selections, and site-specific requirements. Get a free estimate for your property →

Design & Permitting

Rummy Dechner led the design, working within the existing structure to produce a layout that maximized the space without compromising livability. The floor plan tucked the bathroom and laundry along one wall, opened the kitchen to a small living/dining area, and positioned the sleeping space to take advantage of natural light from the existing window openings.

One of the goals from the start was that this shouldn't look like a converted garage when it was done. The exterior — new wall infill where the garage door was, updated siding, windows, and entrance treatment — presents as a cohesive unit rather than an afterthought. Inside, finish selections were residential throughout.

The city permitting process moved faster than expected. A well-prepared, complete permit application is the single biggest driver of permit speed. This submission came back approved with no correction rounds.

Garage Conversion vs. Detached ADU — Which Is Right for You?

The question we get most often from Convoy and mid-city San Diego homeowners: is a garage conversion or a new detached ADU the better move? The honest answer depends entirely on your lot, your goals, and your budget.

Factor Garage Conversion Detached ADU
Typical cost $100K–$180K $200K–$400K+
Timeline 6–9 months 10–14 months
Size potential Limited by existing garage footprint Up to 1,200 sq ft (per lot allowance)
Design flexibility Work within existing structure Fully custom from ground up
Rental income potential $1,500–$2,500/month (typical range) $2,500–$4,500+/month
Foundation work Existing slab — no new foundation Full foundation required
Parking loss Yes — no replacement required by law No parking lost
Best for Lower budget, faster timeline, existing structure Maximum value, larger space, higher rental income

Garage Conversion ADU — Frequently Asked Questions

Can any garage be converted to an ADU in San Diego?

Most attached and detached garages in San Diego can be converted to an ADU, but it depends on your specific zoning, lot size, and setback requirements. The garage must meet minimum ceiling height requirements (typically 7 ft finished height) and the structure must be able to support insulation, waterproofing, and the plumbing and electrical needed for a habitable unit.

A quick property assessment with us will confirm whether your garage qualifies and what the conversion would require.

Do I lose my parking if I convert my garage to an ADU?

California state law prohibits cities from requiring replacement parking when a garage is converted to an ADU. You do not need to provide a new covered parking space. However, if maintaining parking matters to you, options include a carport addition or converting only part of the garage if it's large enough to split.

This Convoy project had no parking replacement requirement. The homeowners simply lost the garage parking — which they weren't using anyway.

How long does a garage conversion ADU take in San Diego?

A garage conversion ADU typically takes 6–9 months from first consultation to certificate of occupancy. That breaks down as design and drawings (6–10 weeks), city permitting (60–90 days), and construction (2–3 months). This project took approximately 7 months total.

Garage conversions are significantly faster than detached ADU builds (10–12 months) because no foundation work is required — you're working within an existing structure.

How much does a garage conversion ADU cost in San Diego?

In 2025–2026, a permitted garage conversion ADU in San Diego typically costs $100,000–$180,000 depending on size, finish level, and site conditions. This Convoy project came in at $150,000 for a 425 sq ft unit with a full kitchen, bathroom, sleeping area, and stackable laundry.

The main cost drivers are plumbing rough-in (if new), electrical panel upgrades, insulation, drywall, kitchen and bathroom finishes, and exterior work to infill the garage door opening.

Do I need a permit to convert my garage to an ADU?

Yes — a permit is required for any garage-to-ADU conversion in San Diego. The city reviews plans for structural compliance, energy code (Title 24), fire safety, plumbing, and electrical. Permit fees typically run $5,000–$15,000 for a garage conversion ADU in San Diego.

Unpermitted conversions create serious problems when you sell or refinance, and cannot be legally rented. Every garage conversion we build is fully permitted with a certificate of occupancy.

What's the difference between a garage conversion and a detached ADU?

A garage conversion works within an existing structure — lower cost ($100K–$180K), faster timeline (6–9 months), but limited square footage and design flexibility constrained by the existing garage footprint.

A detached ADU is built from the ground up — more design freedom, larger potential size, higher rental income potential, but significantly higher cost ($200K–$400K+) and longer timeline (10–14 months). The right choice depends on your lot, budget, and goals. We can walk through both options at your property assessment.

Have a Garage You're Not Using?

A permitted garage conversion is typically the lowest-cost path to adding livable space on your property. We handle design, permits, and construction — one team, start to finish.
